Project Updates
Stay up to date on the progress of Lakewood Warehouses — our premium office and warehouse project in Lakewood Ranch, Florida. We’ll be sharing construction milestones, photos, and site developments as we move toward completion.
📅 November 11, 2025 — Pad Prep Complete

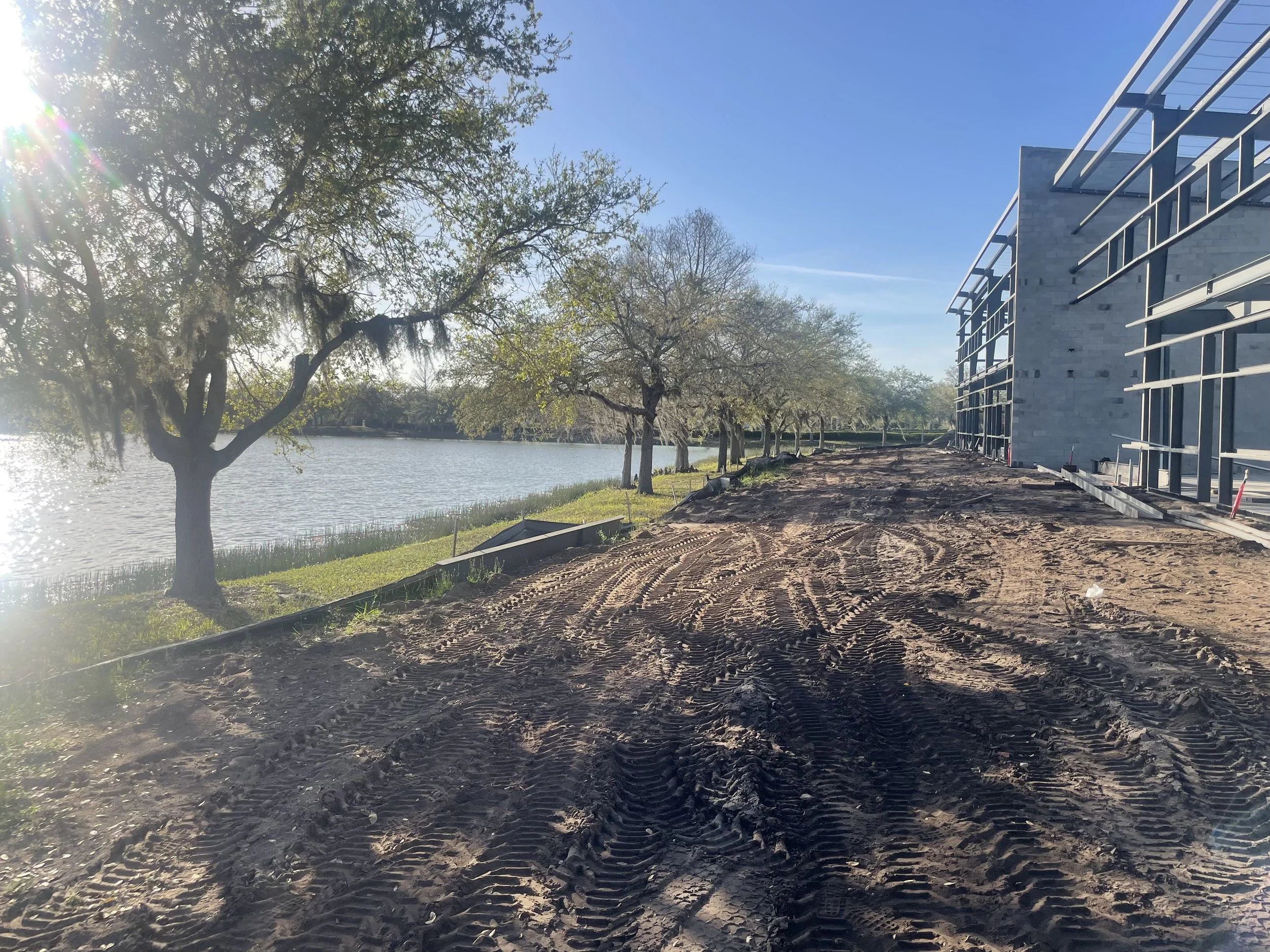

Exciting progress on site! The pad prep is officially complete, and the boards are now going up for the concrete slabs. The property is taking shape exactly as planned, with the building footprints now clearly visible from the road.
Over the next phase, crews will begin running underground utility lines for both buildings. Once that’s complete, we’ll pour the slabs and begin with the masonry work.
We’ll continue to post photo updates and milestones as we move closer to our target move-in date of July 1, 2026.
Stay tuned — progress is moving fast, and leasing opportunities are already active.

📅 February 2, 2026 — Slab + block

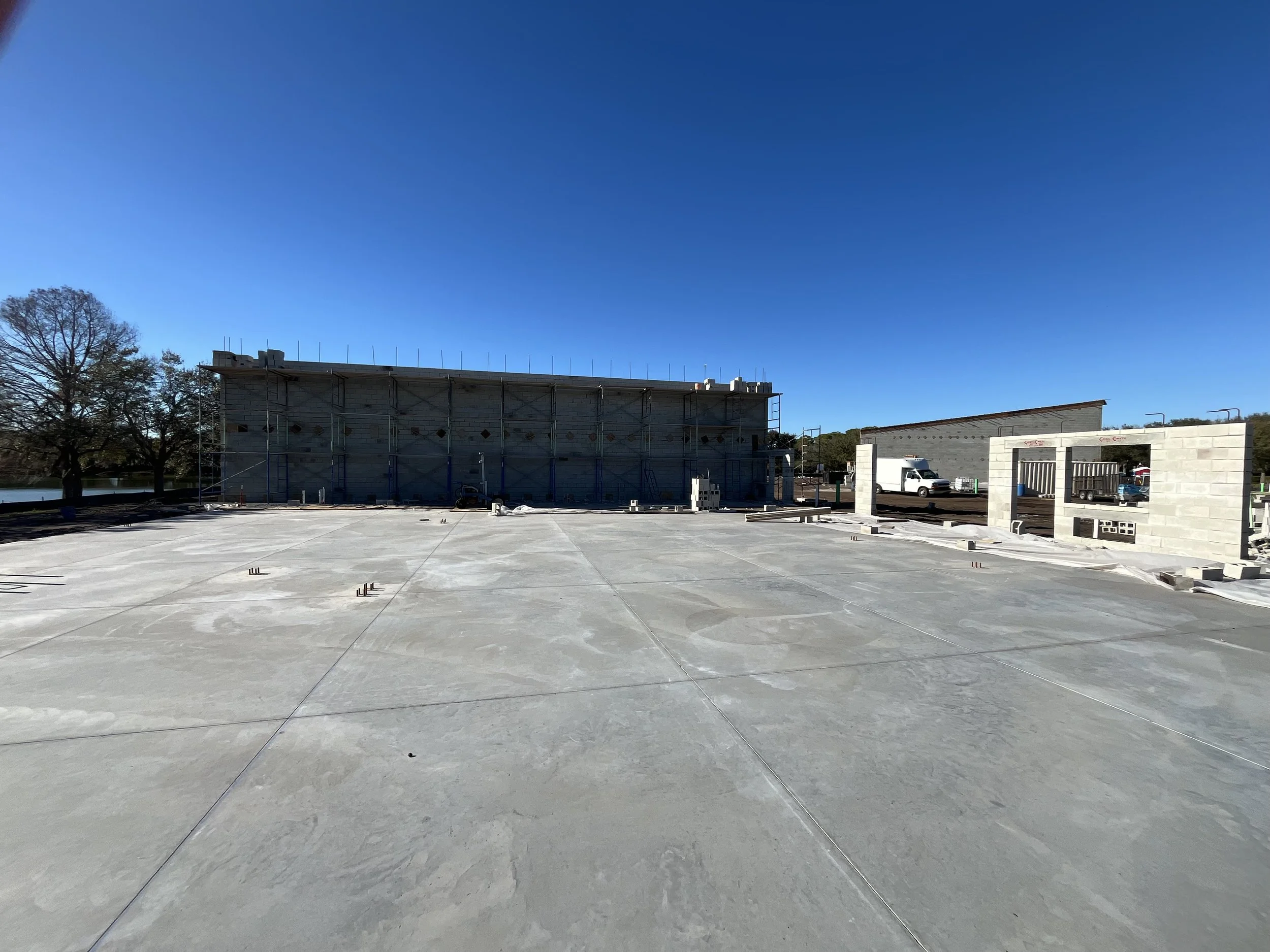

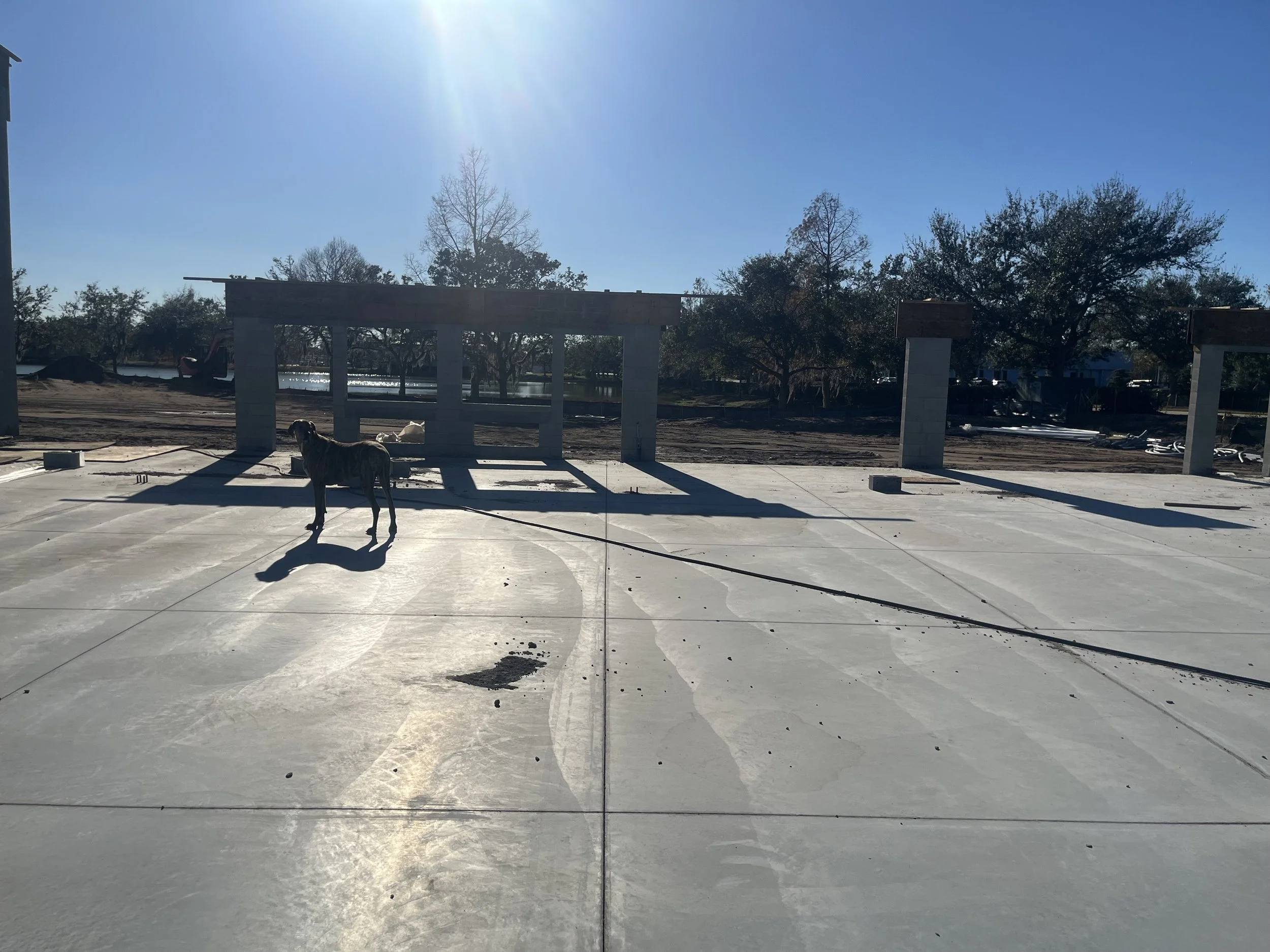

The slab tested out at nearly 5000 lbs in 30 days. At 6 inches with both steel and microfiber reinforcement, it is strong. The edges are nearly 2.5 feet deep as footers.
Feedback has included “ridiculously overbuilt.”
We think it is important that it lasts.

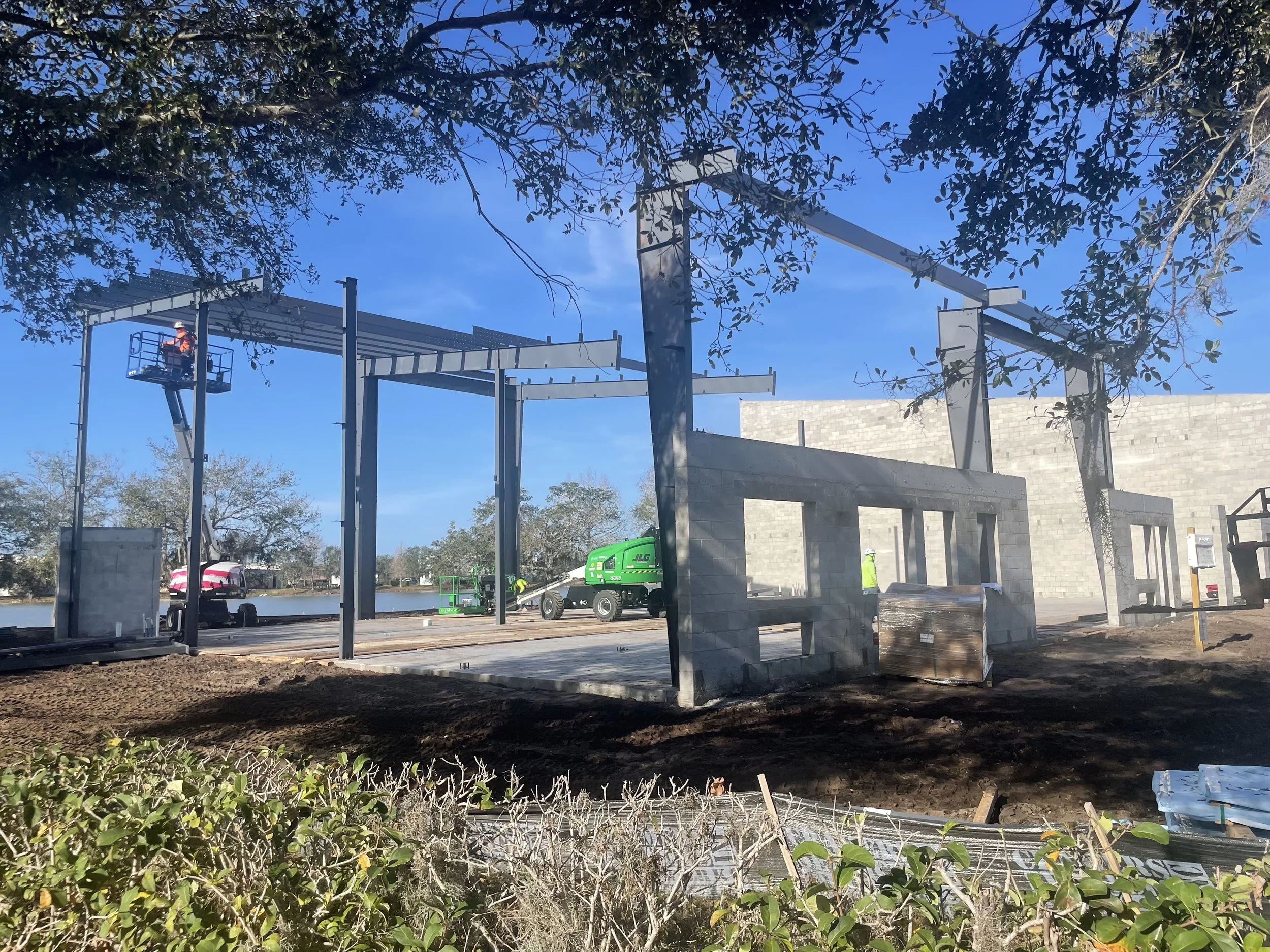

📅 February 19, 2026 — steel

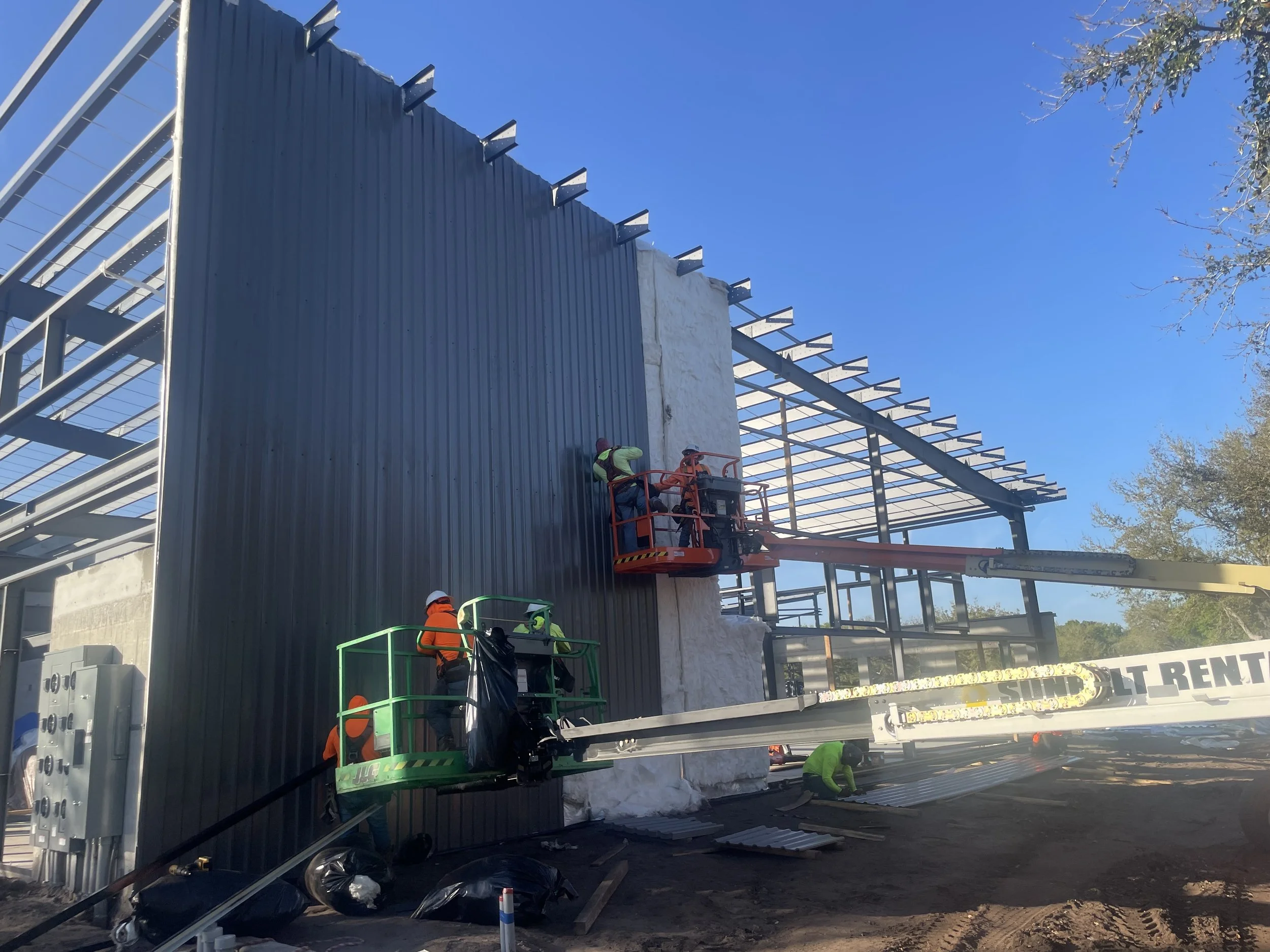

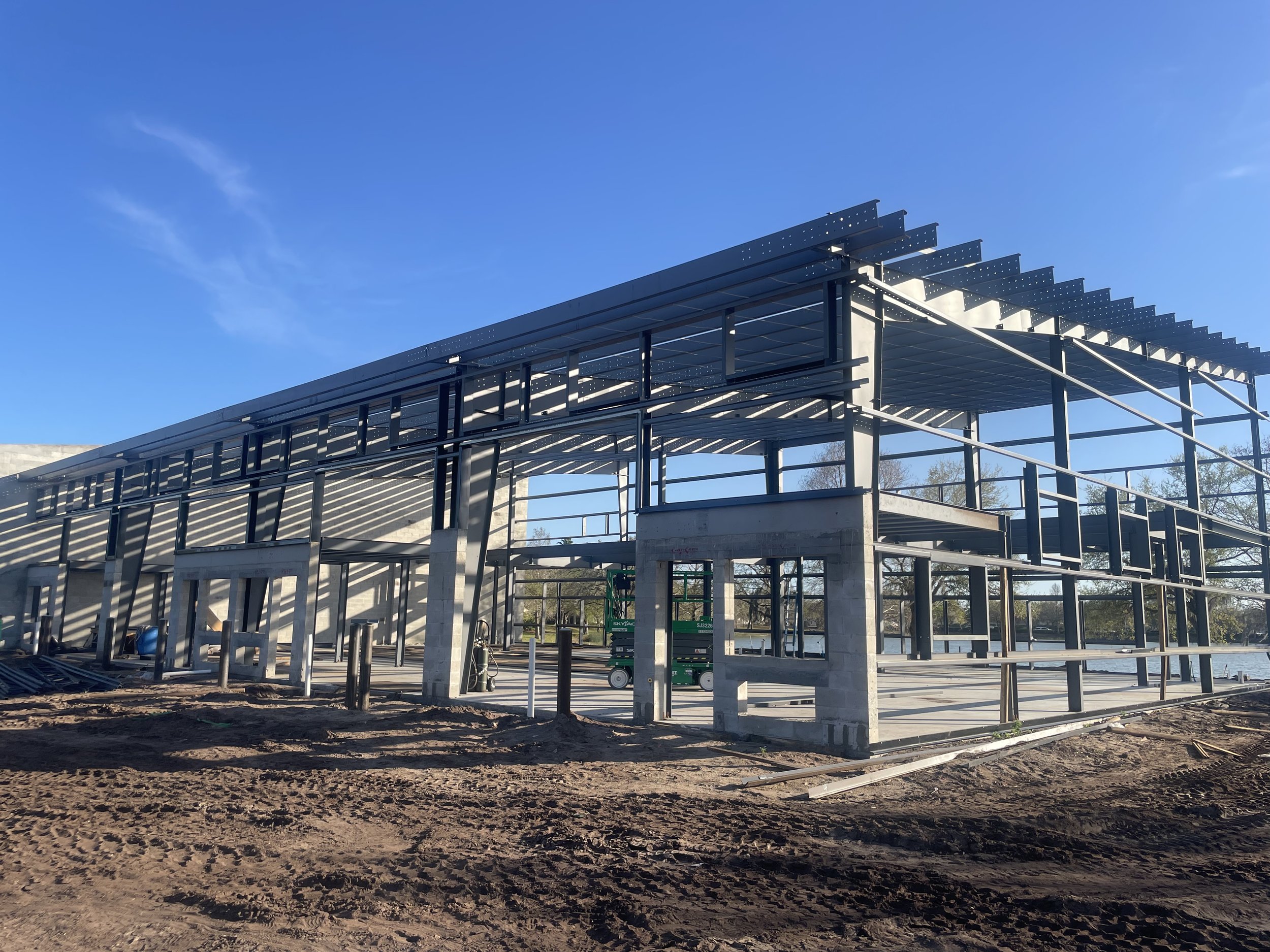

Steel is starting to go up which is always a fun part of the process.
The metal should take about a month.
📅 march 13, 2026

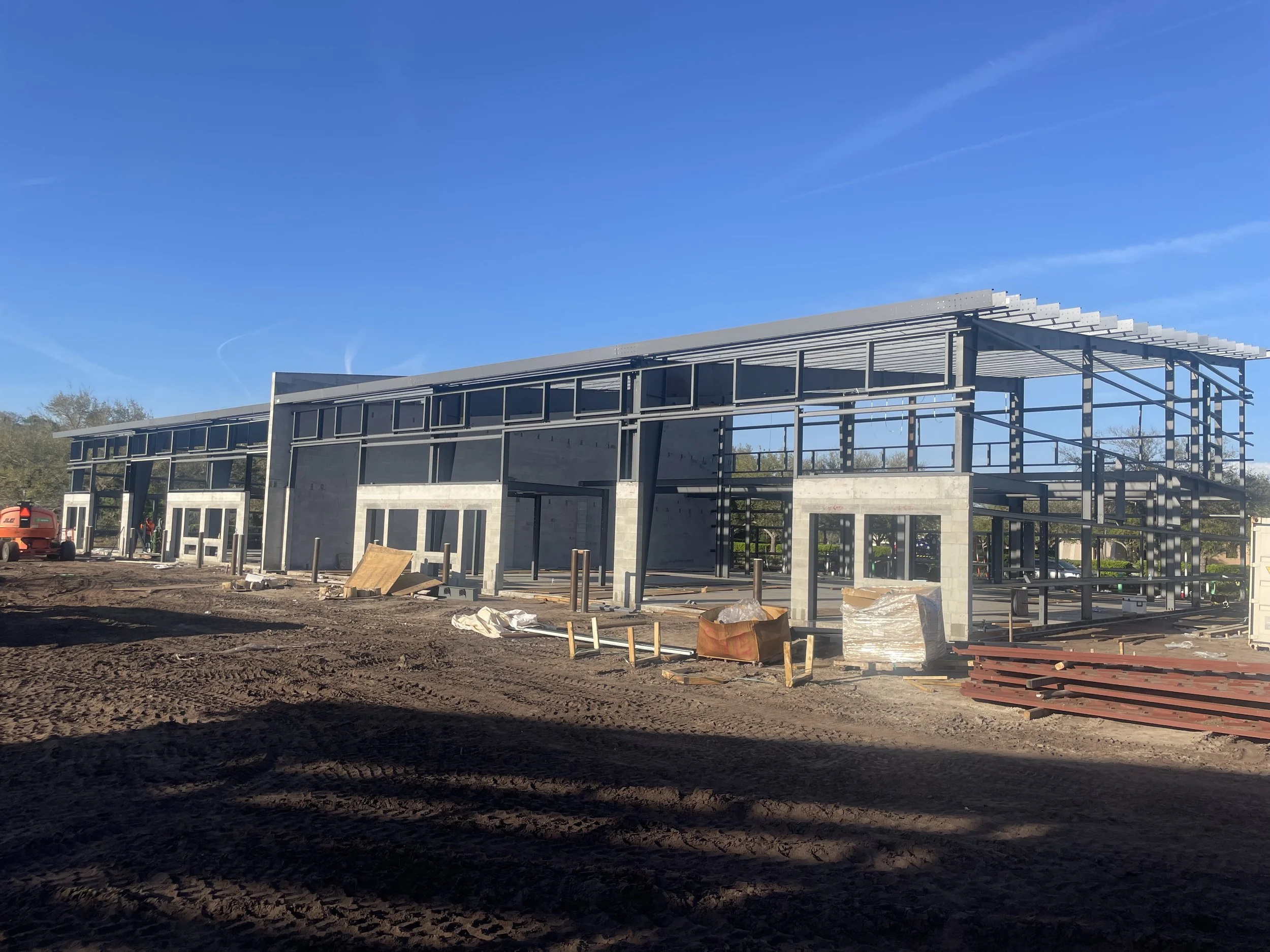

Structural steel is up and the walls are going on.

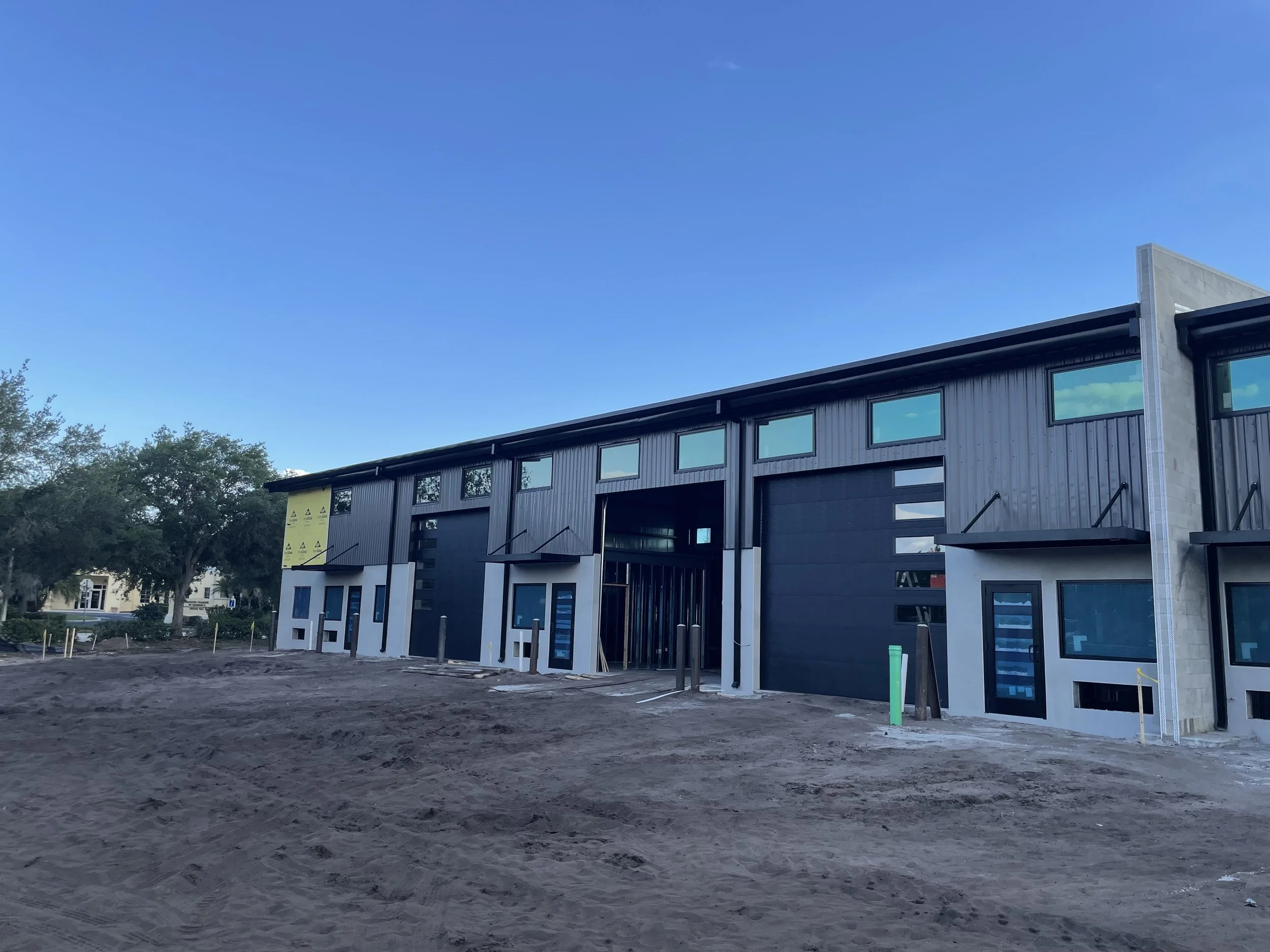

📅 April 15, 2026
Progress!
📅 April 23, 2026

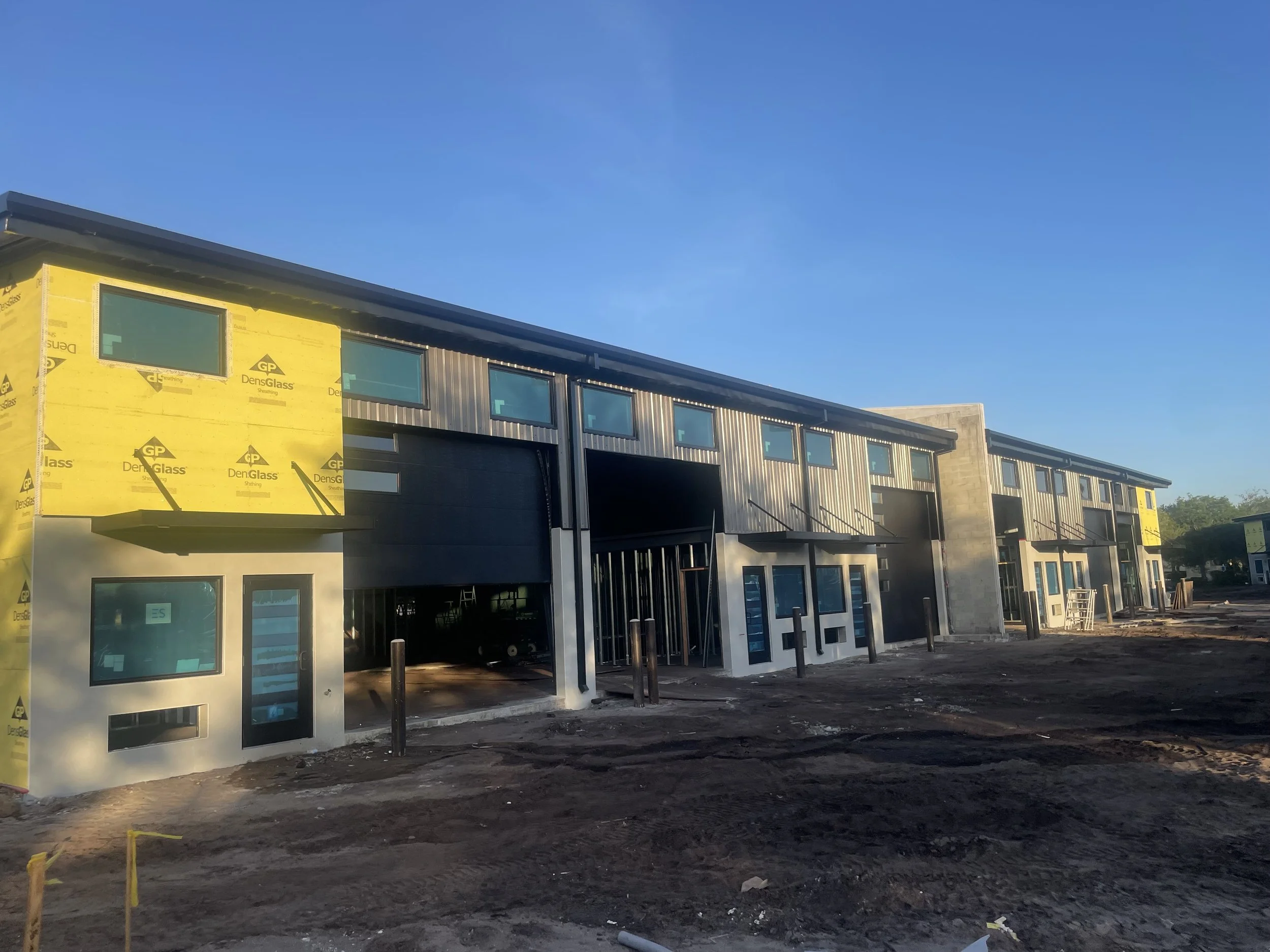

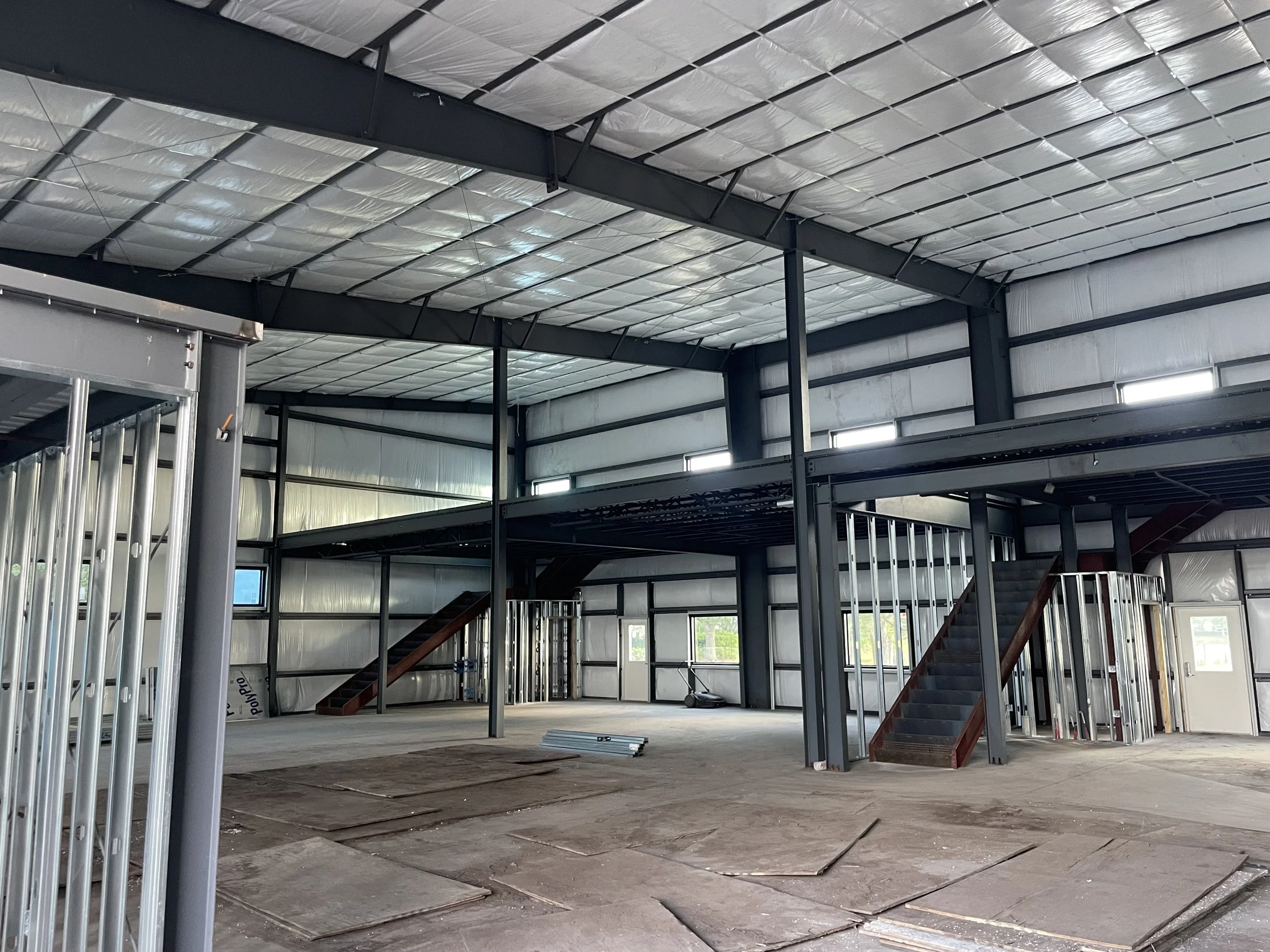

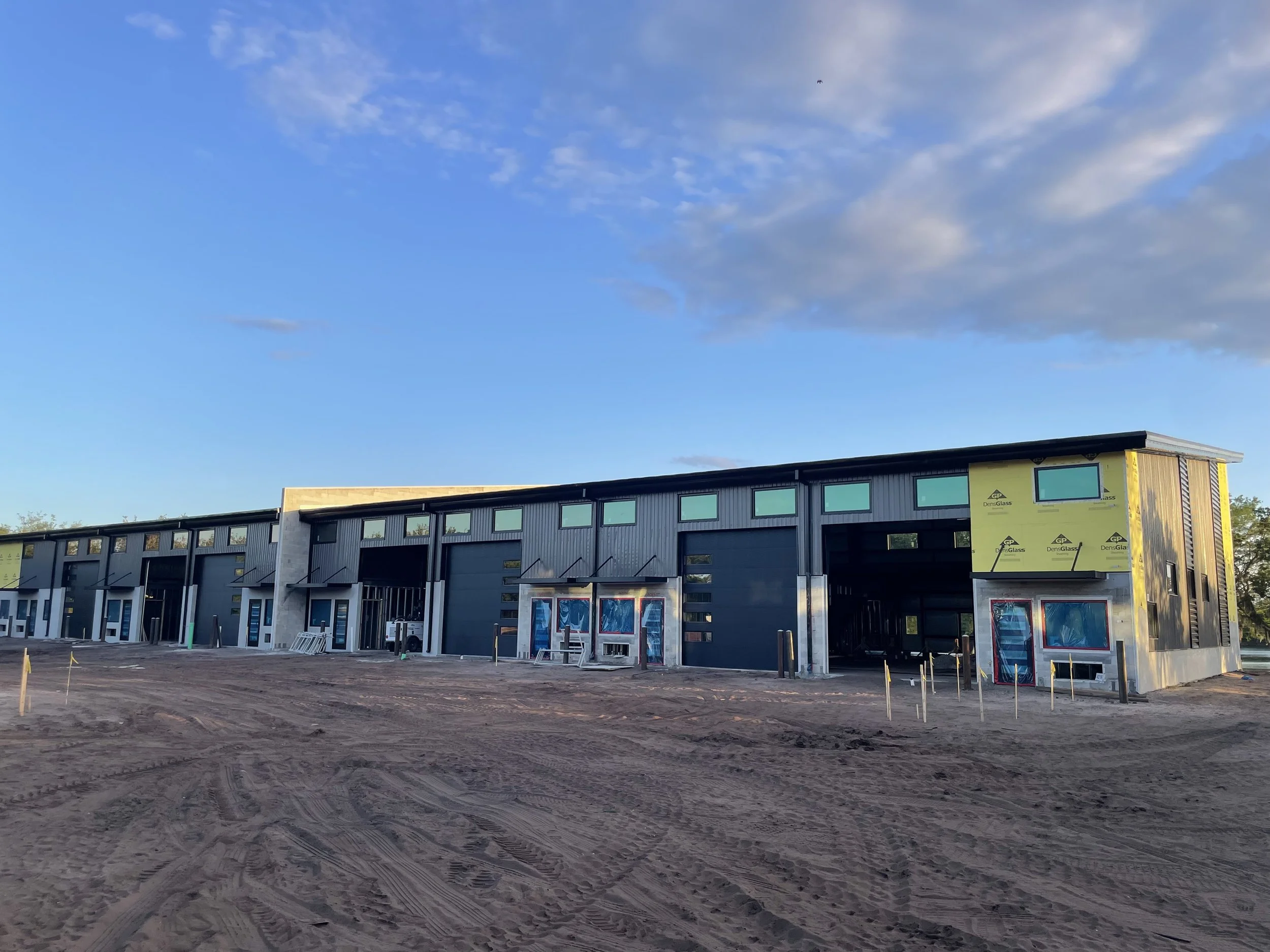

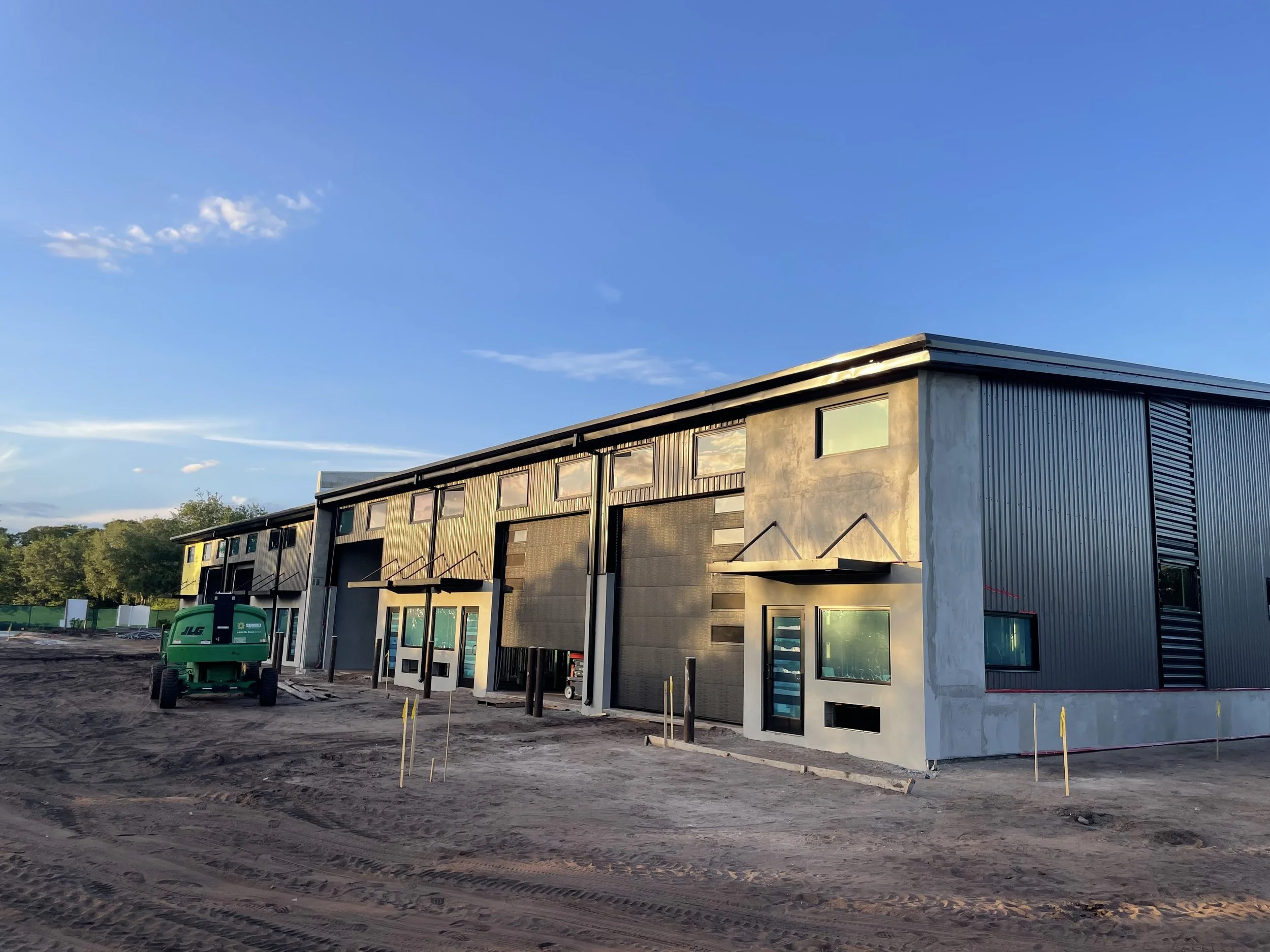

Pardon the mess, things are really starting to move fast! All the windows and man doors are in. The overhead doors should be finished in the next few days. Concrete for the upper level and sidewalk out front should be completed in the next week along with the stucco. Offices and bathrooms should all be framed by Monday.
We look forward to the site contractor coming back late next week to begin putting in the base for the pavement. While he does that, we will complete framing and continue with electrical, HVAC, and plumbing.

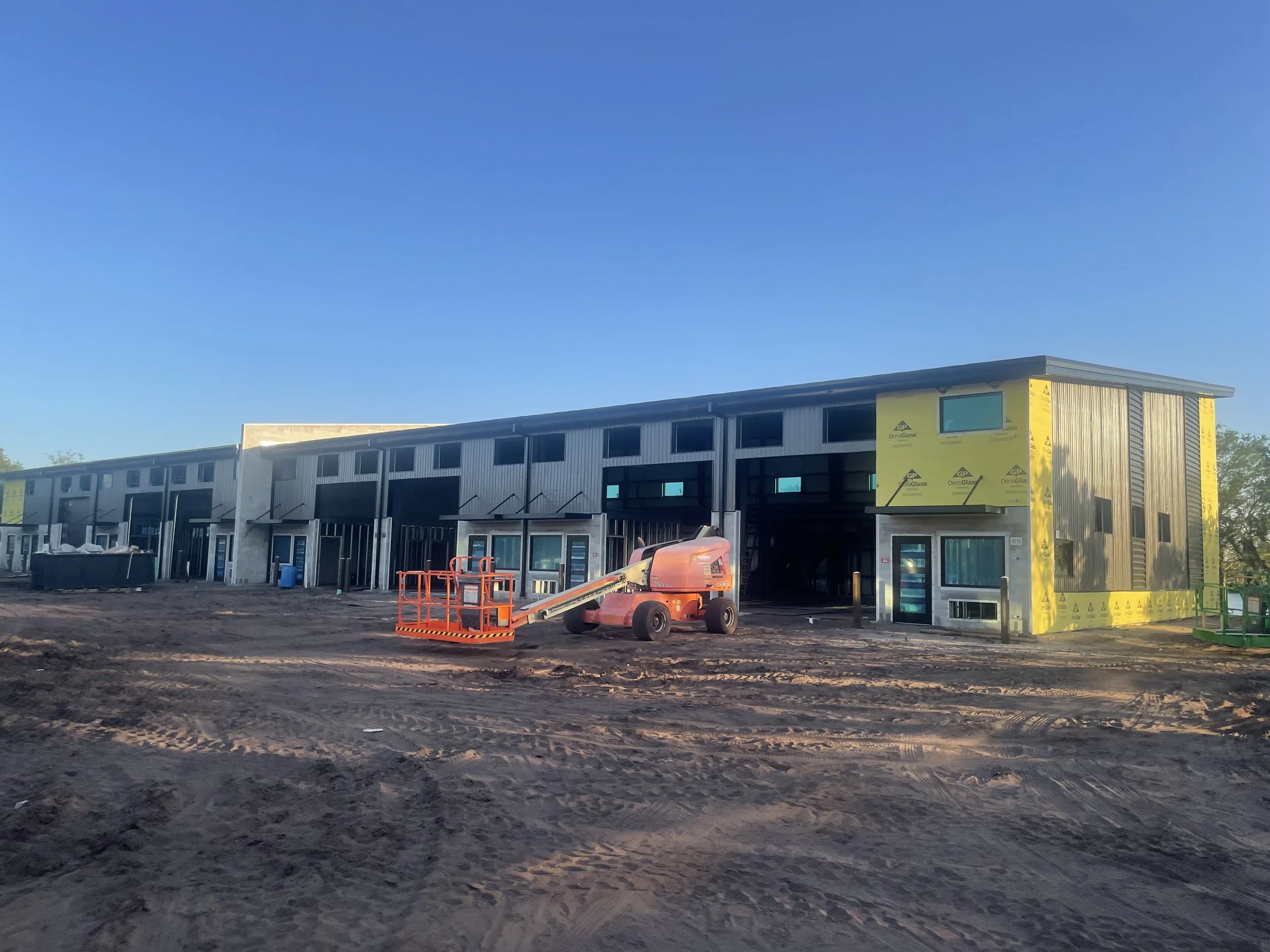

📅 MAY 15, 2026

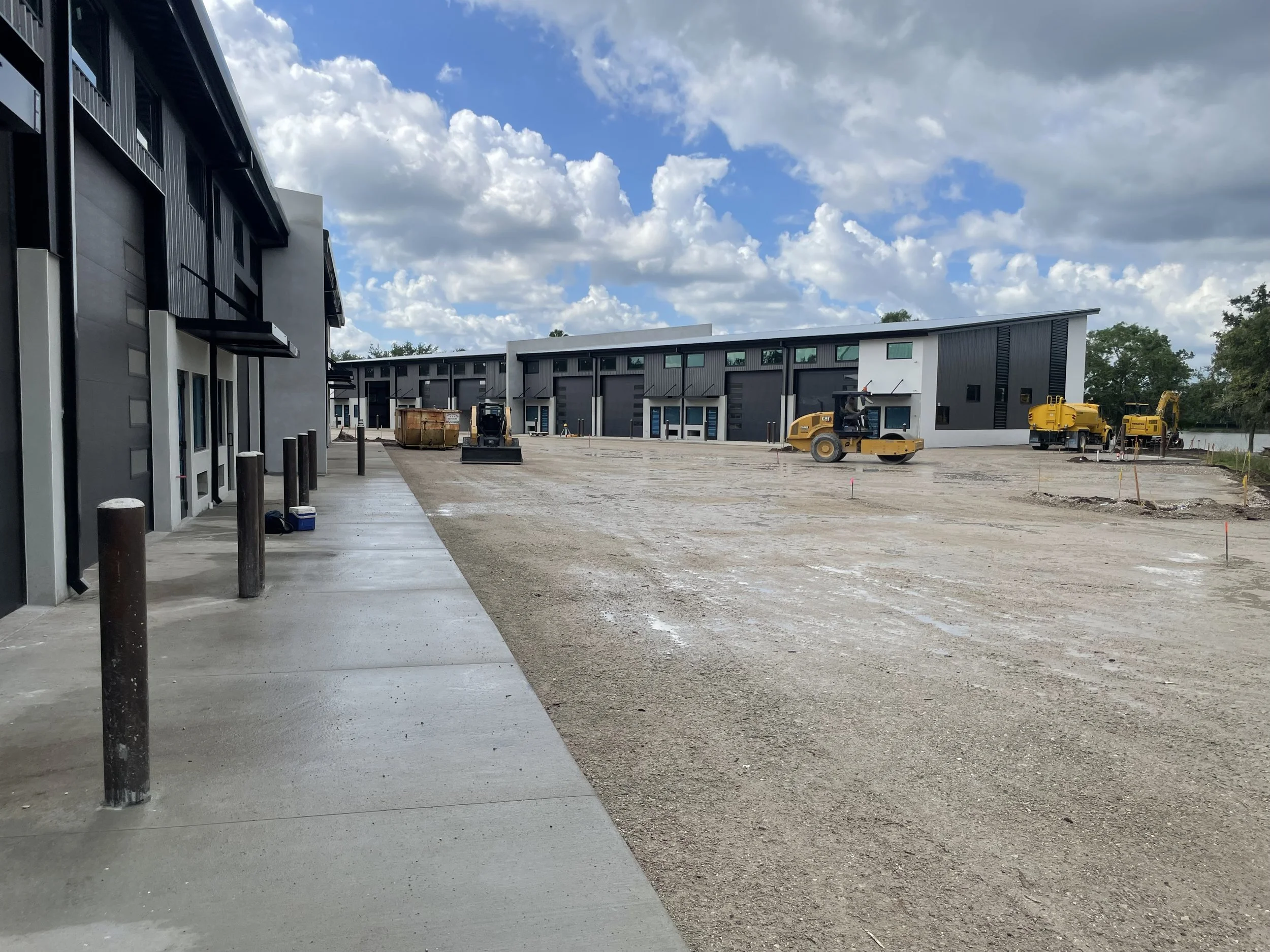

Sidewalks are in, asphalt compaction is nearly complete, and plumbing and electrical work continues inside. Great progress across the site as the project keeps moving forward.
📅 MAY 20, 2026
It looks a lot better with some paint… looking forward to asphalt and irrigation going in next week. Plumbing, electrical, and railings continue inside.
📅 MAY 29, 2026

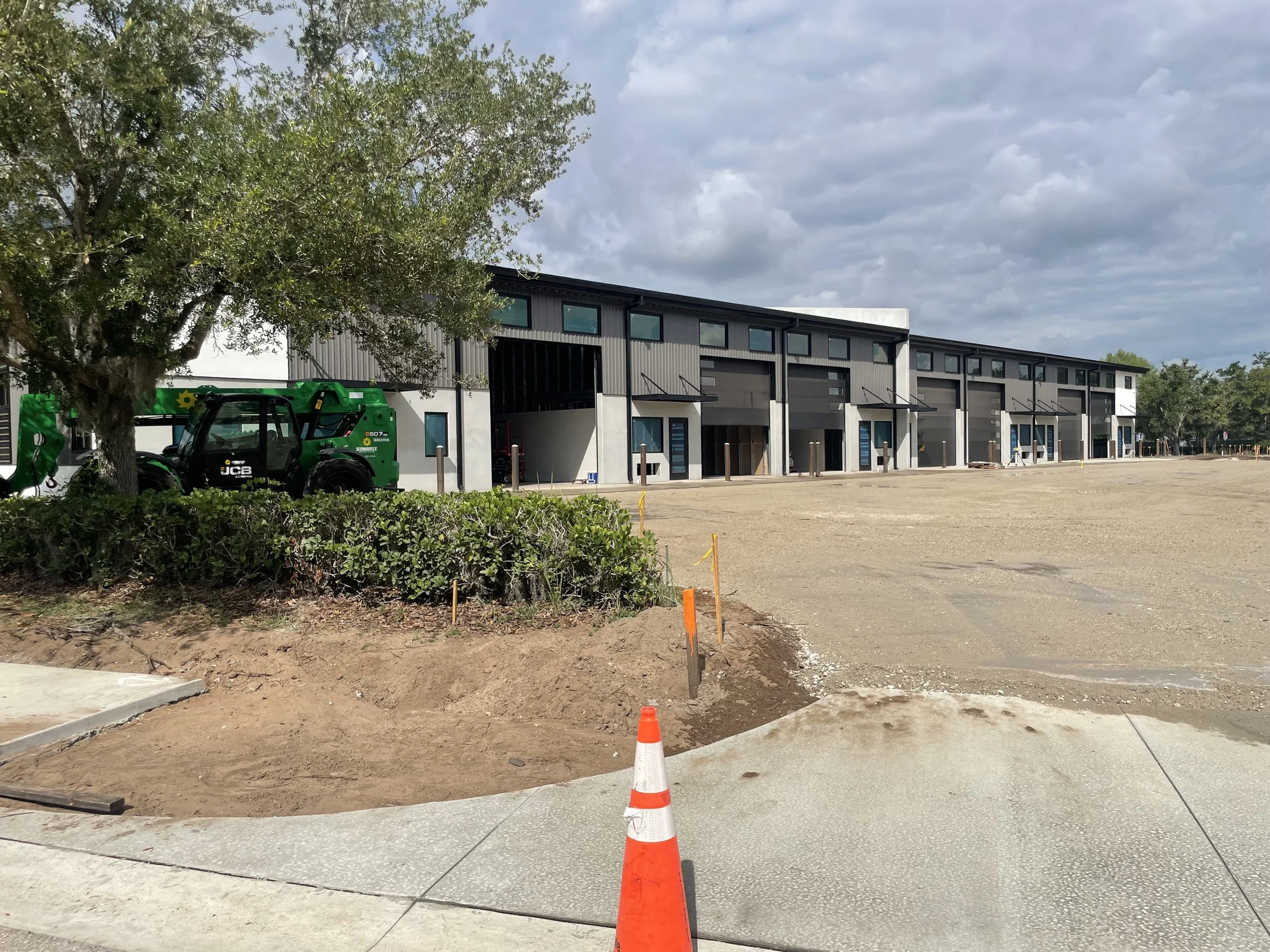

This week we got asphalt! Irrigation is going in. The interior walls are getting sound deadening insulation and then closed up. The electricians are finished with the walls and will now do the exterior lighting and then the ceiling lights. The AI cameras are going in. Air handlers are almost all placed. Final grading, curbs, landscaping kickoff, and a lot of wall work coming up next week.
📅 June 12, 2026

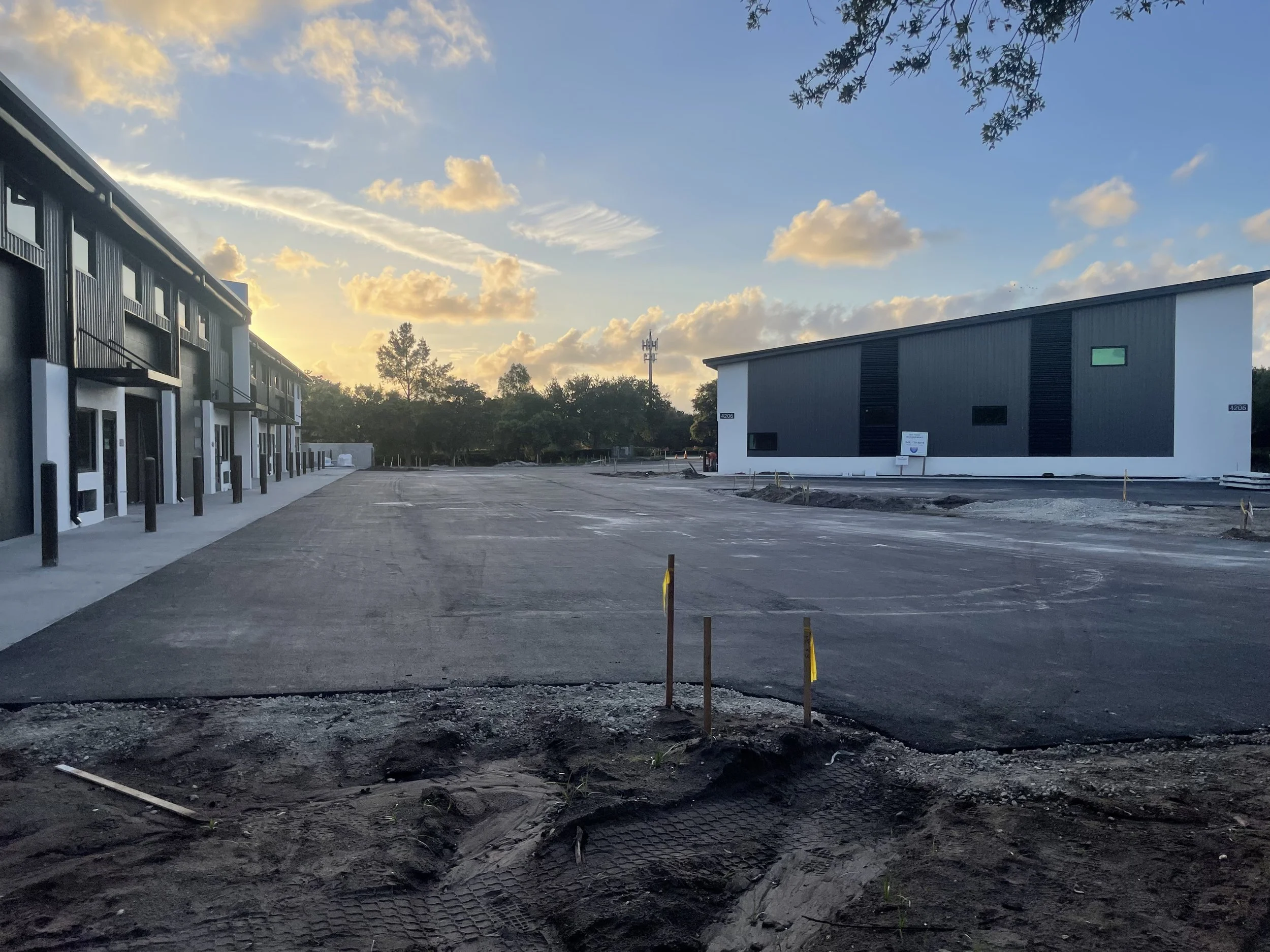

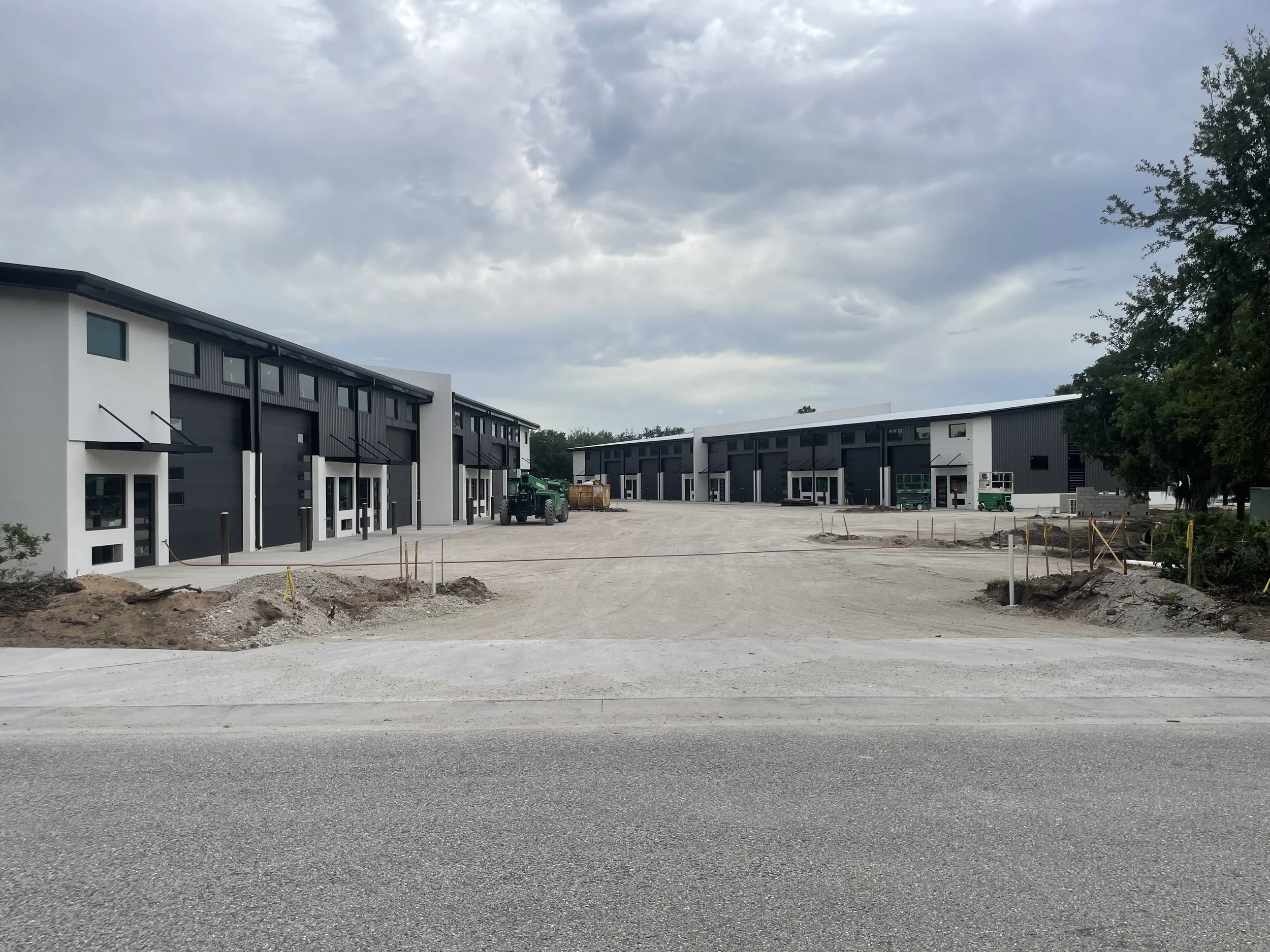

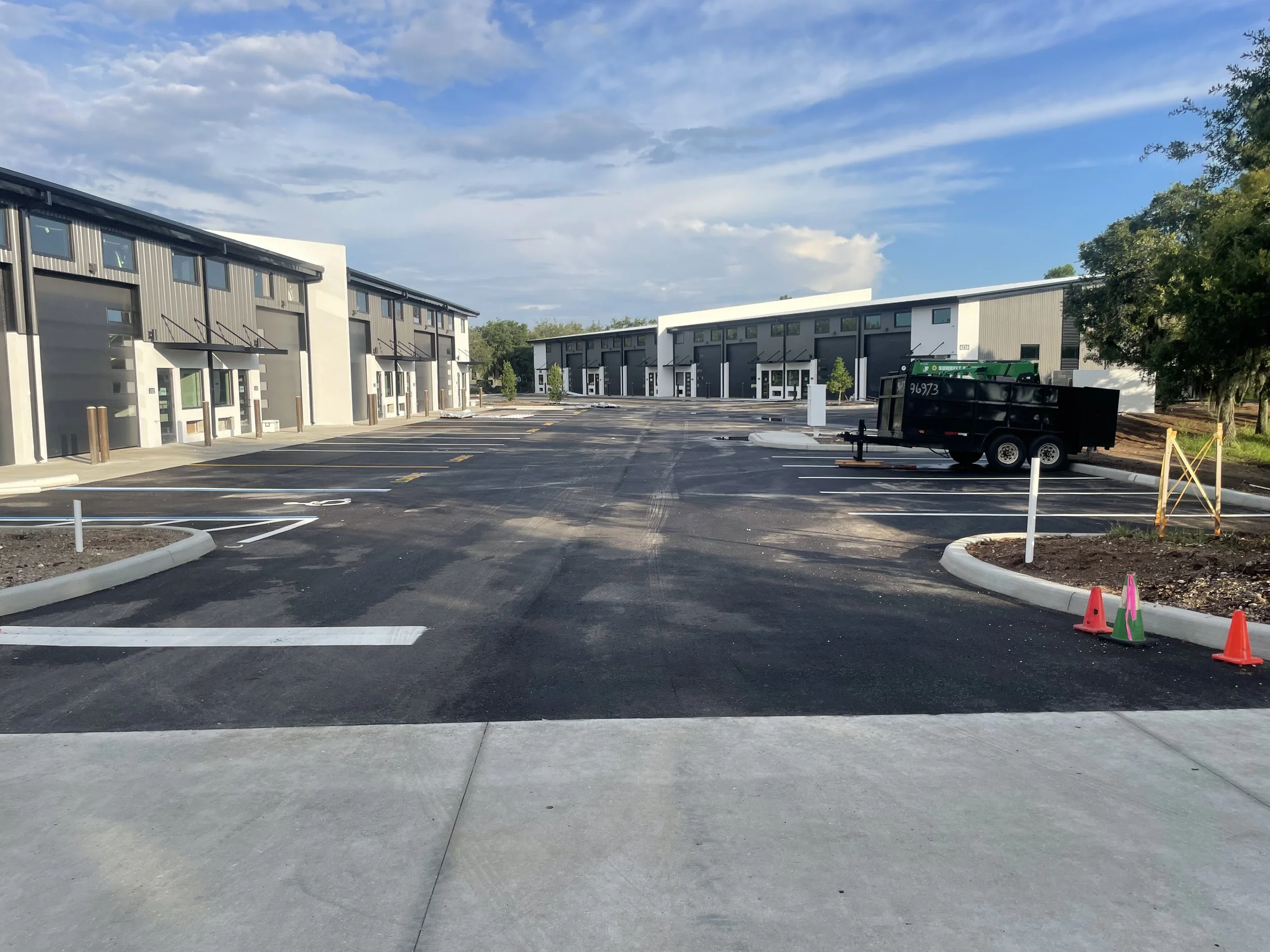

This week: parking lot striped, a lot of the trees and plants in, irrigation nearly complete, Drywall sheets almost fully installed and finishing started, interior metals (walls and railing) nearly complete, water meter approved, and house electric meters installed. Check out the view from someone’s back door!
Next week we expect to get individual power meters, hopefully a water meter, plants and irrigation will complete, interior painting begins, floor grinding starts, drywall and finishing continue, cabinets and plumbing final installs begin, and hopefully we get a unit cleaned up to show you. The next couple weeks will be big weeks! Sod comes on the 22nd.
Lots of leasing activity and we expect we will only have 2 spaces left next week. Give us a call or shoot us a note if interested.

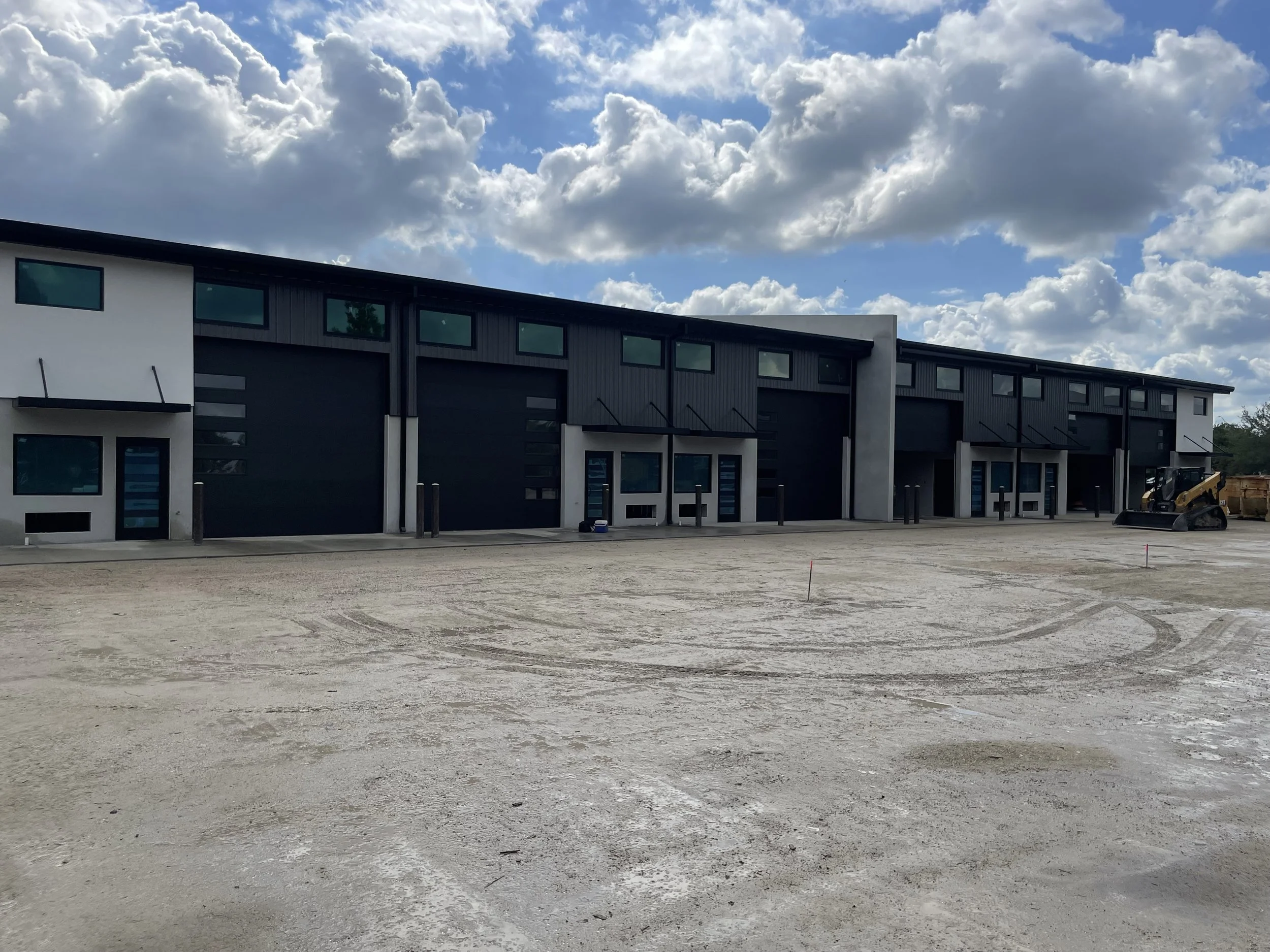

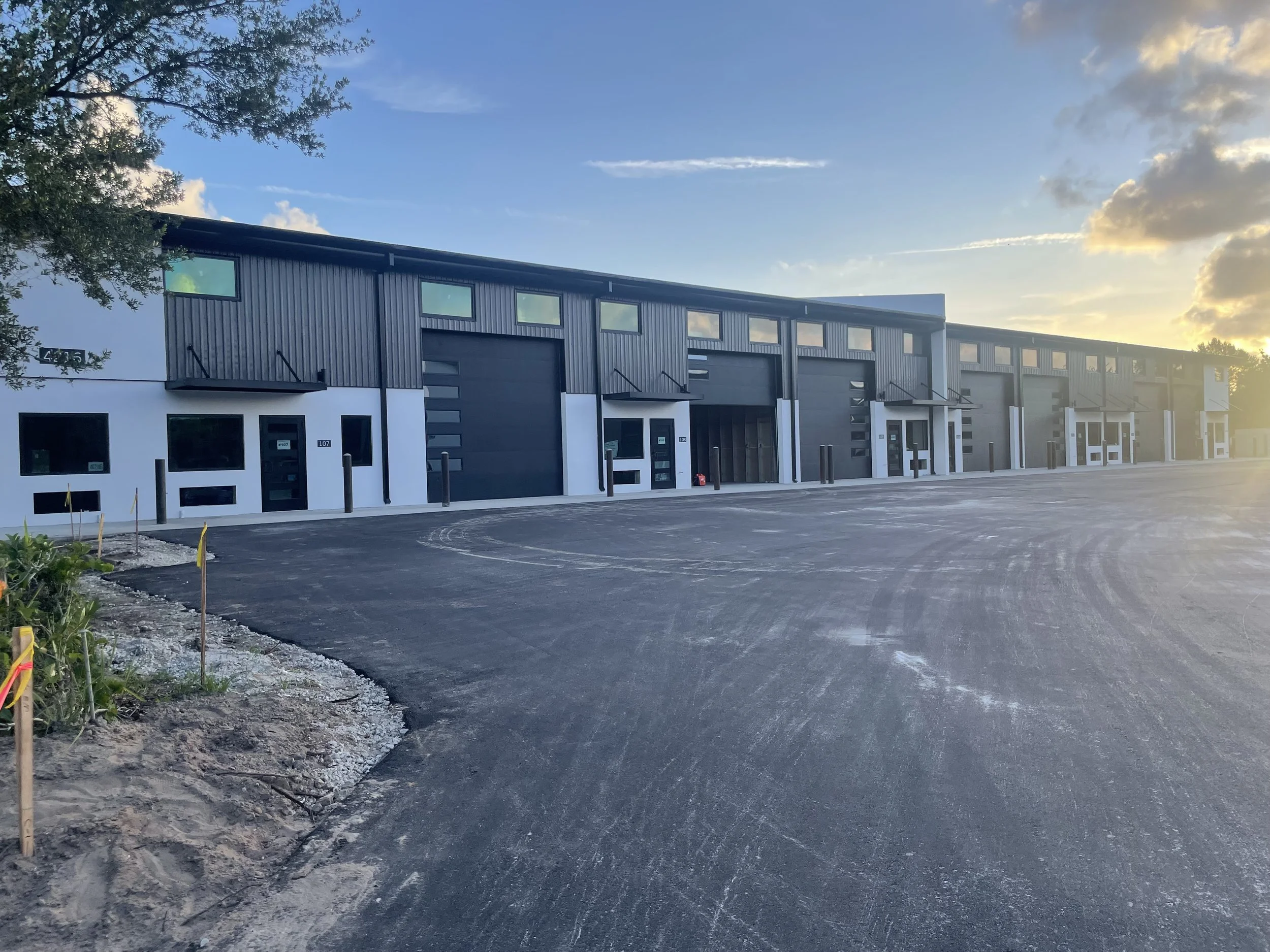

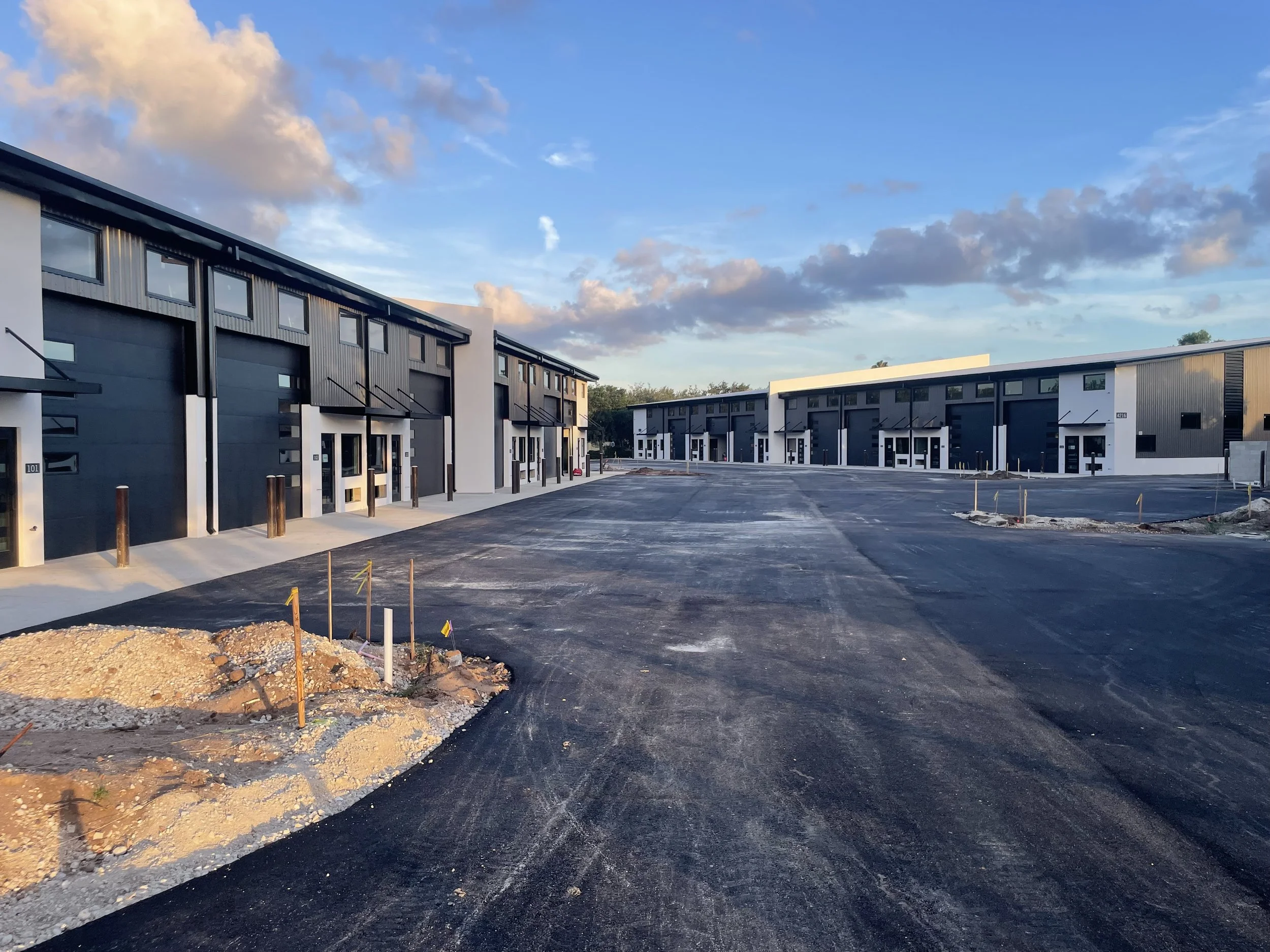

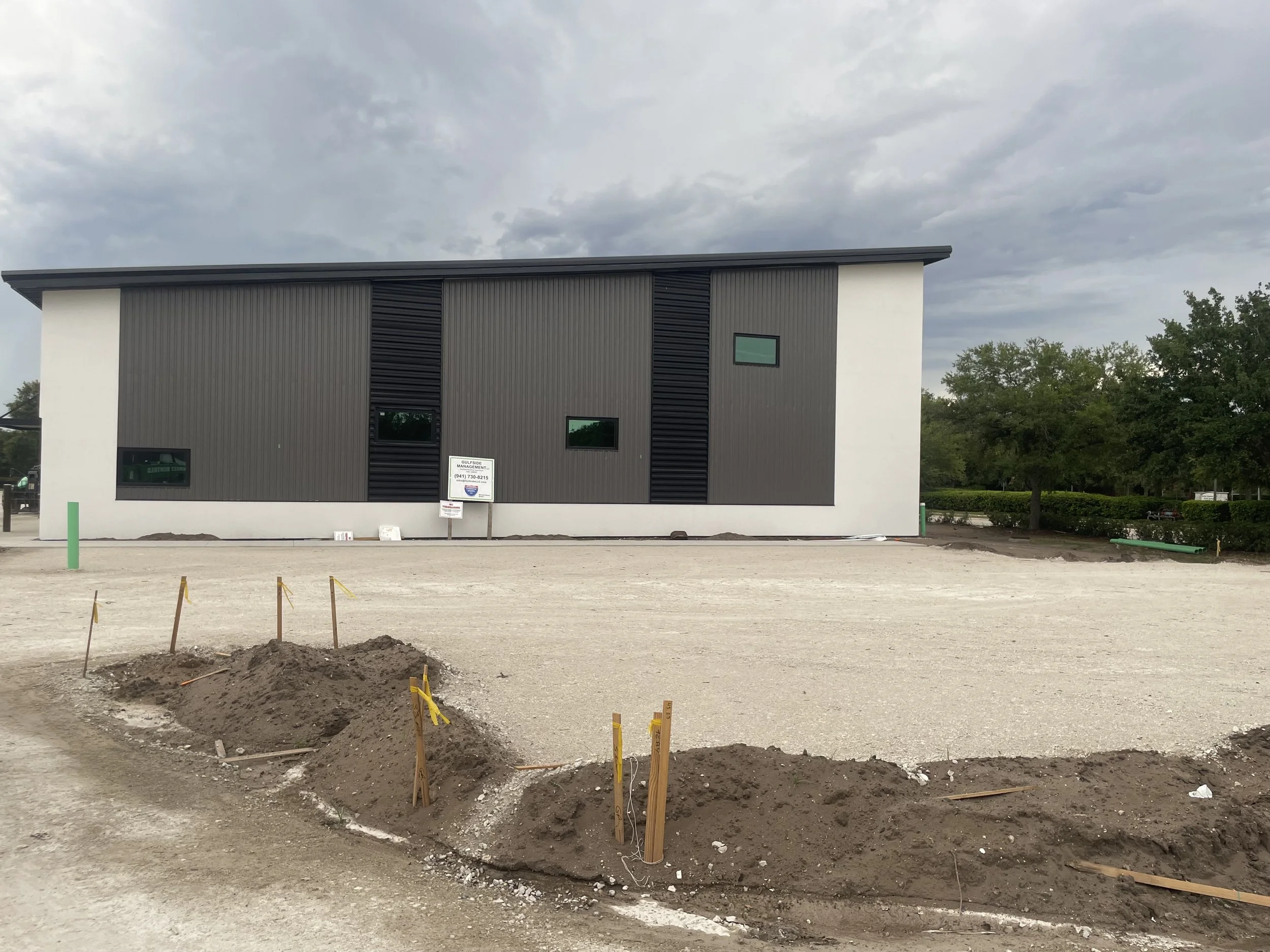

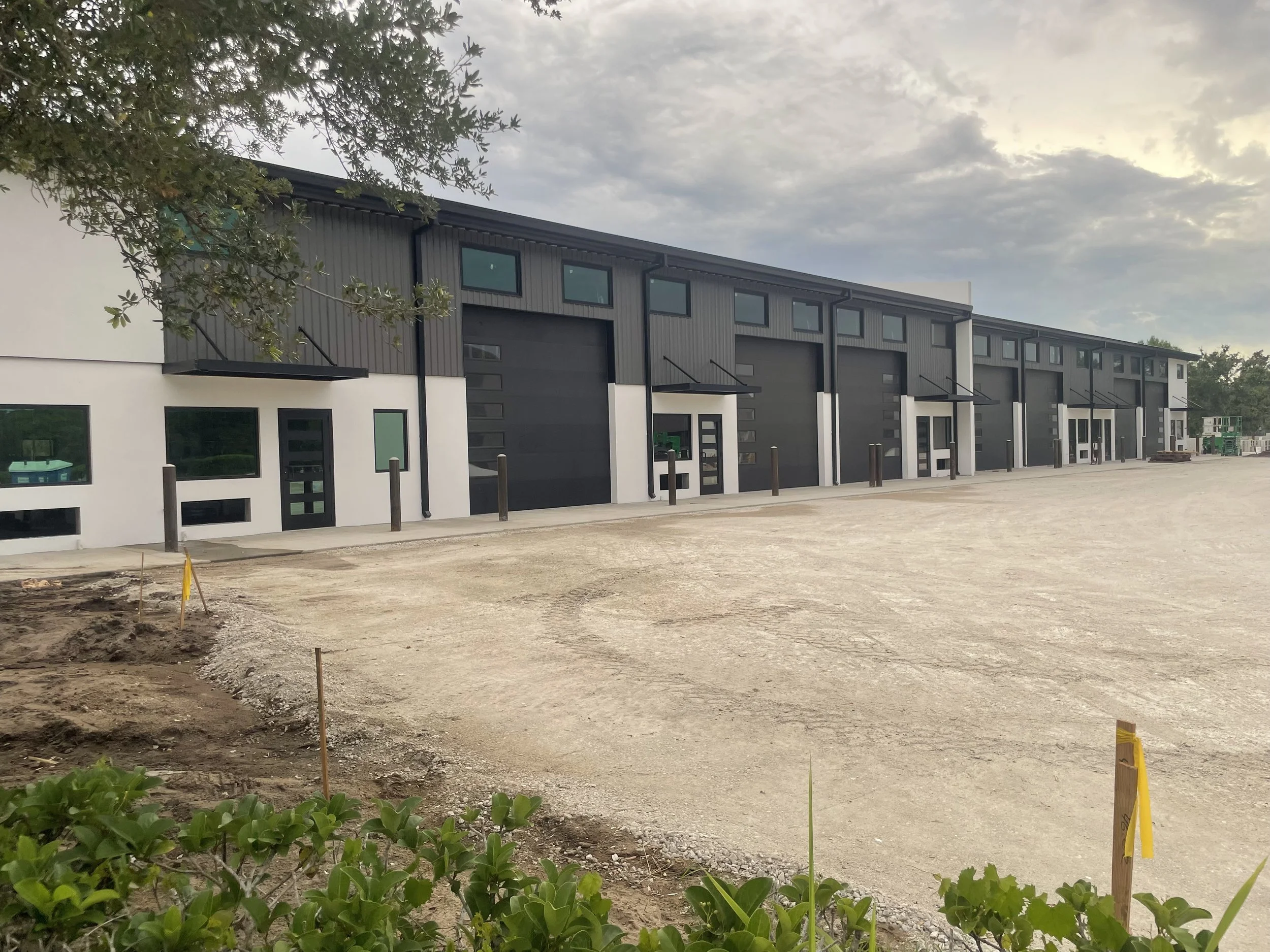

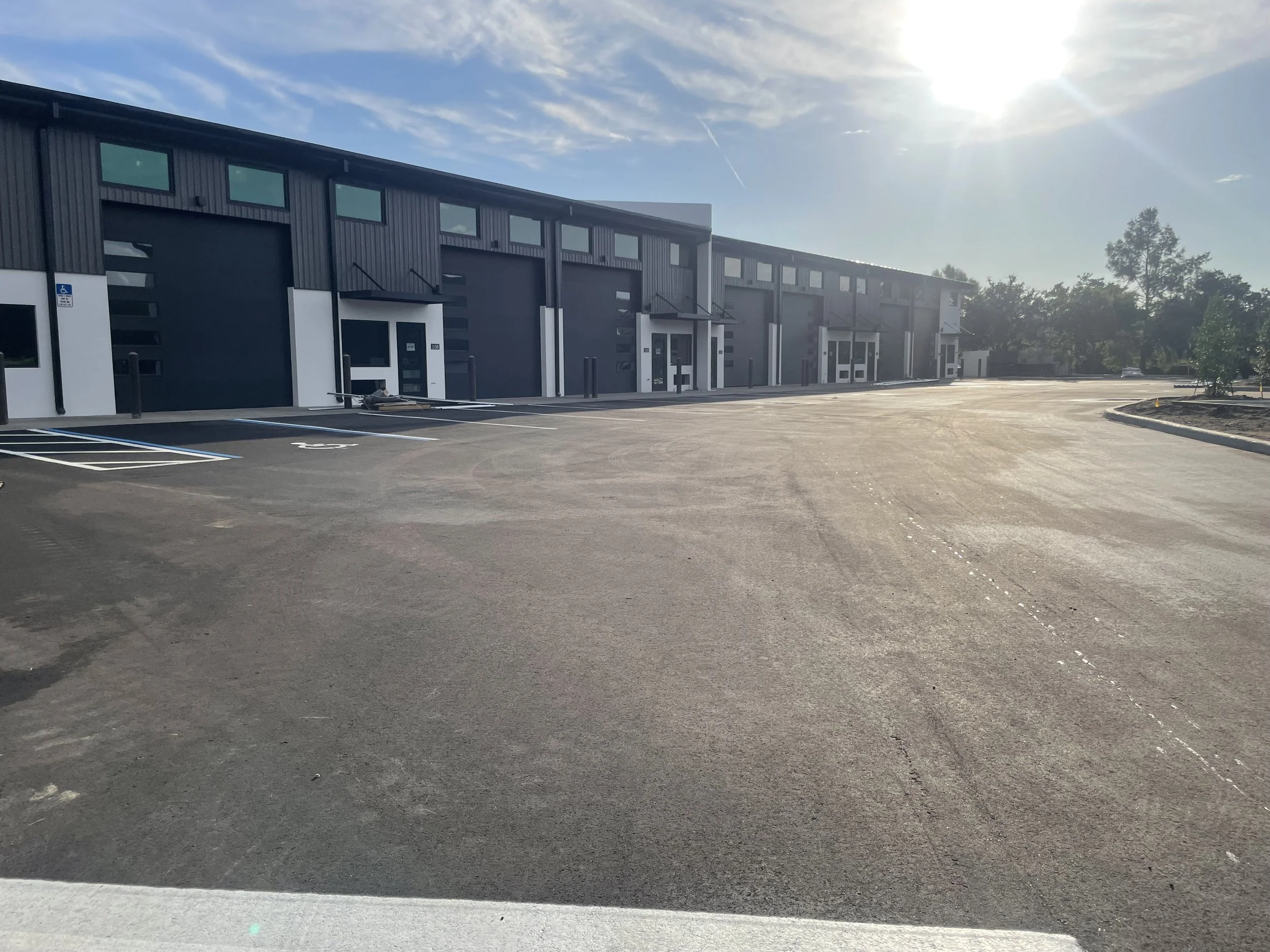

📅 July 3, 2026

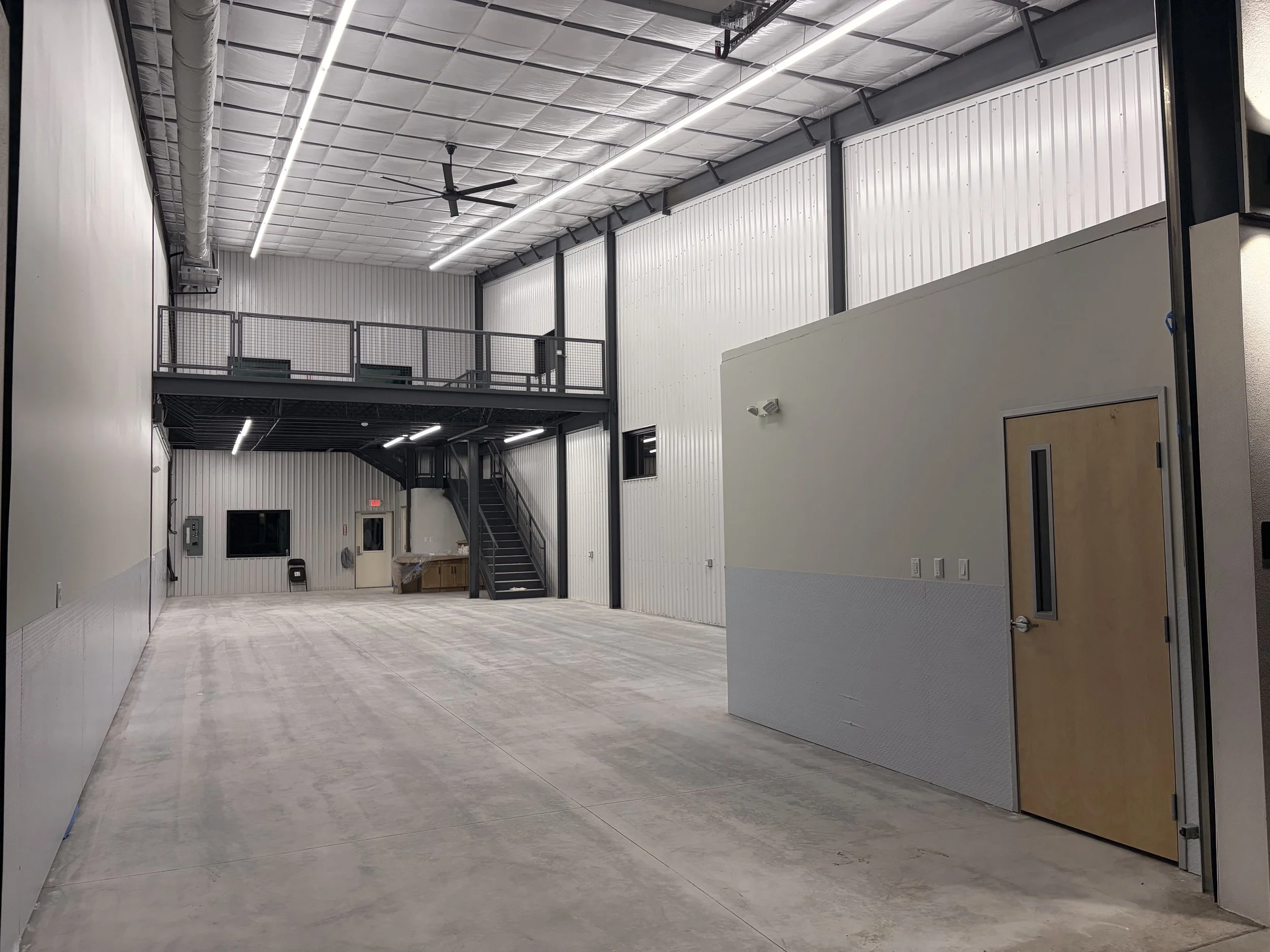

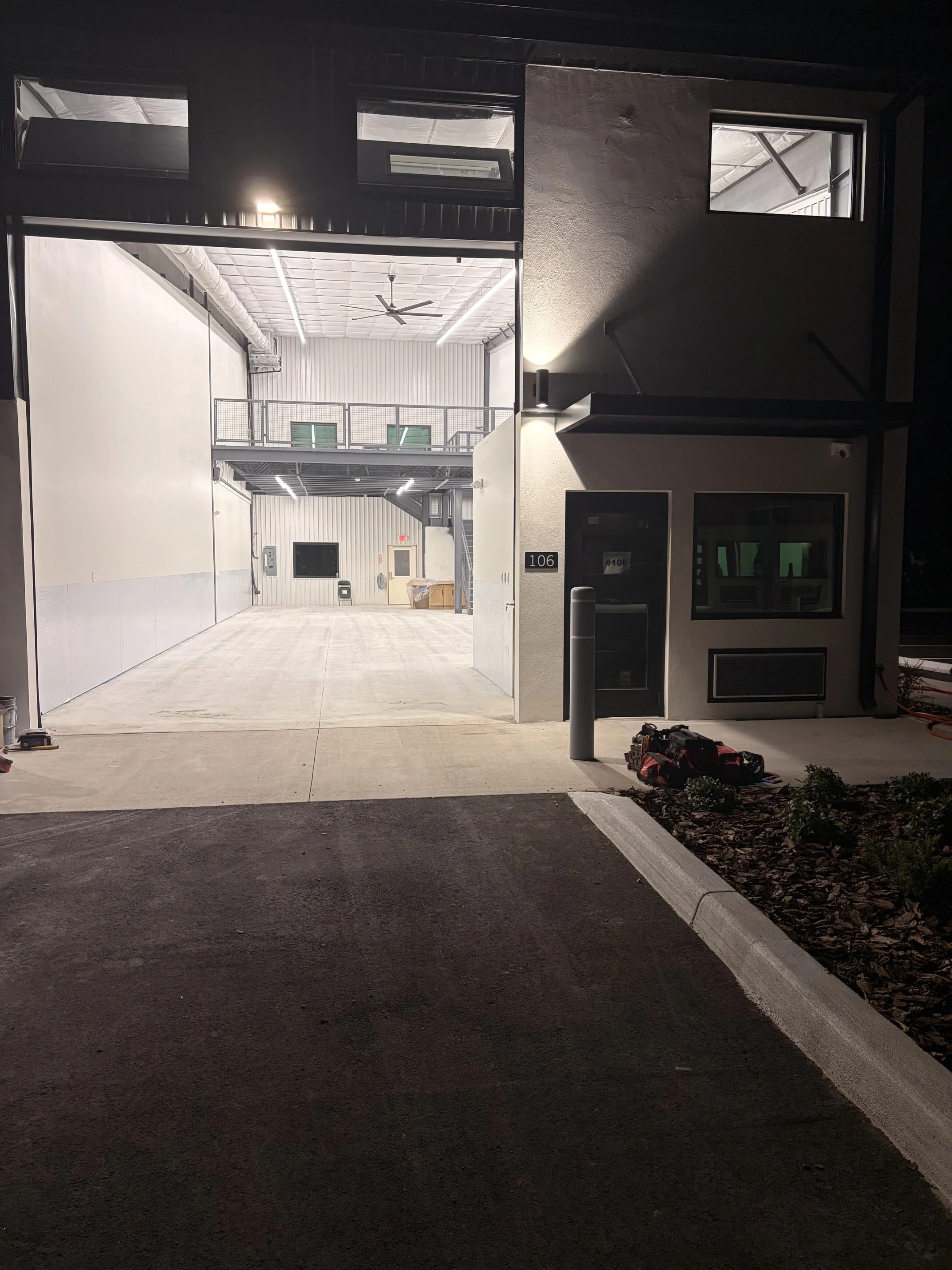

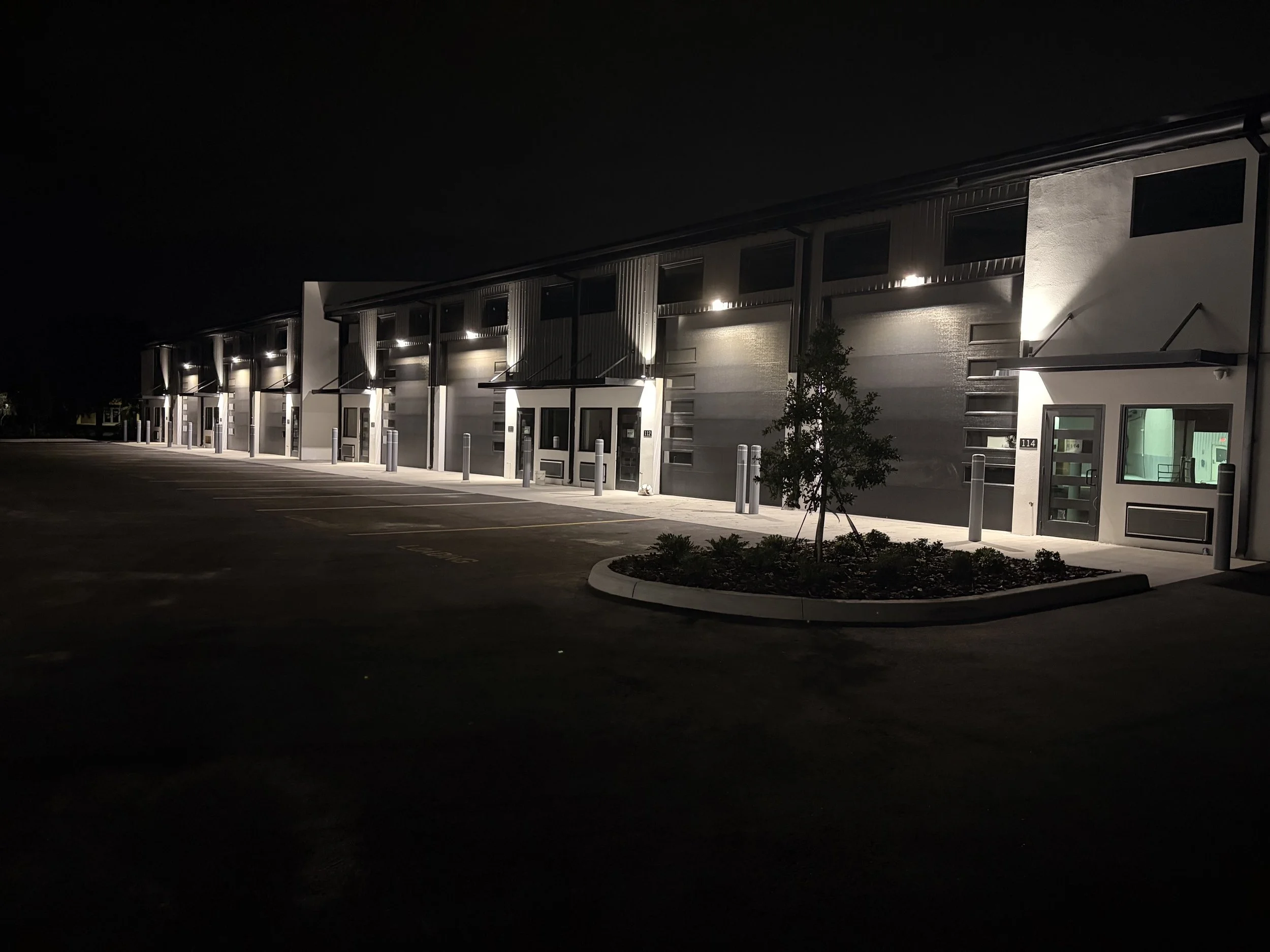

We are working hard to finish the first six spaces with some late night floor grinding. The lights came out great.
Next Update Coming Soon…
